Skip to main content

Free Pool and Spa Estimate Templates (2026)

Free Pool and Spa Estimate Templates (2026)

Quick answer: A new gunite inground pool costs about $50,000 to $100,000 in 2026, with a 16x32 pool and basic features near $90,000. A pool renovation runs about $35,000, and a hot tub or built-in spa installation about $17,000 to $26,000.

Selling a pool or spa project is exciting. The homeowner is dreaming about backyard parties, lazy weekends, and adding value to their property. But if your estimate looks sloppy, arrives late, or misses key line items, that excitement turns into doubt fast.

Pool and spa work involves dozens of moving parts. You are coordinating excavation, plumbing, electrical, concrete or fiberglass installation, decking, fencing, permits, and inspections. Forgetting even one item on your estimate can cost you thousands in profit or, worse, force an awkward change order conversation that damages the customer relationship.

That is why templates matter. A well-built estimate template gives you a starting framework that covers every category of work. You do not have to rebuild your estimate from scratch for each job. Instead, you adjust quantities, swap out materials, and update pricing for the specific project. The result is a faster, more accurate, more professional estimate that wins more jobs.

In this guide, you will find four pool and spa estimate templates. The first covers new inground pool construction. The second handles pool renovation and remodel work. The third is for pre-fabricated hot tub installations, and the fourth is for custom built-in spas. Each template includes realistic 2026 pricing, common line items, and notes on where contractors typically make mistakes.



Why Pool and Spa Estimates Are Different

Pool and spa projects are not like a typical home improvement job. They span multiple trades, require specific permits, and often take weeks or months to complete. This complexity makes your estimate more important, not less.

Here is what makes pool estimates unique:

Multiple phases of work. A new pool job might include demolition (if removing an old pool), excavation, steel reinforcement, plumbing rough-in, electrical rough-in, shell construction, tile and coping, decking, equipment installation, and final filling and startup. Each phase has its own materials, labor, and timeline.

Permit and code requirements. Most cities require building permits for pool construction. Many also require separate electrical permits, plumbing permits, and fencing inspections. Some municipalities require engineered drawings. All of these carry costs that belong on your estimate.

Subcontractor coordination. Unless you run a large operation, you probably subcontract at least some of the work. Excavation, electrical, and fencing are the most commonly subbed out. Your estimate needs to account for subcontractor pricing plus your markup.

Customer expectations are high. Pool buyers are spending $40,000 to $100,000 or more. They expect a detailed, professional estimate that explains every cost. A one-page estimate with three line items will not cut it at this price point.

Change orders are common. The homeowner sees the hole in the ground and suddenly wants a deeper end, a built-in bench, or upgraded tile. A detailed original estimate makes change orders easier to price because you already have a baseline cost for each item.

Template 1: New Inground Pool Construction

This template covers a standard residential inground pool project. The example uses a 16x32 gunite pool with basic features. Adjust the dimensions, materials, and pricing for your specific project.

Project Information

Every estimate starts with the basics:

  • Customer name and address
  • Project address (if different)
  • Estimate date and expiration date (30 days is standard)
  • Estimated start date and completion date
  • Pool type, dimensions, and depth
  • Payment terms and schedule

Excavation and Site Work

Line ItemUnitQtyUnit CostTotal
Site survey and layouteach1$400.00$400.00
Excavation (16x32 pool, 3.5ft to 8ft depth)lump sum1$4,500.00$4,500.00
Soil hauling and disposalload8$350.00$2,800.00
Backfill and gradinglump sum1$1,200.00$1,200.00
Erosion control and silt fencelinear ft120$3.50$420.00

Subtotal: $9,320.00

Notes: Excavation costs vary dramatically based on soil conditions. Rocky soil can double the excavation price. Always check soil conditions before quoting. If the access is tight (narrow side yard, existing landscaping), you may need a smaller excavator, which takes longer and costs more.

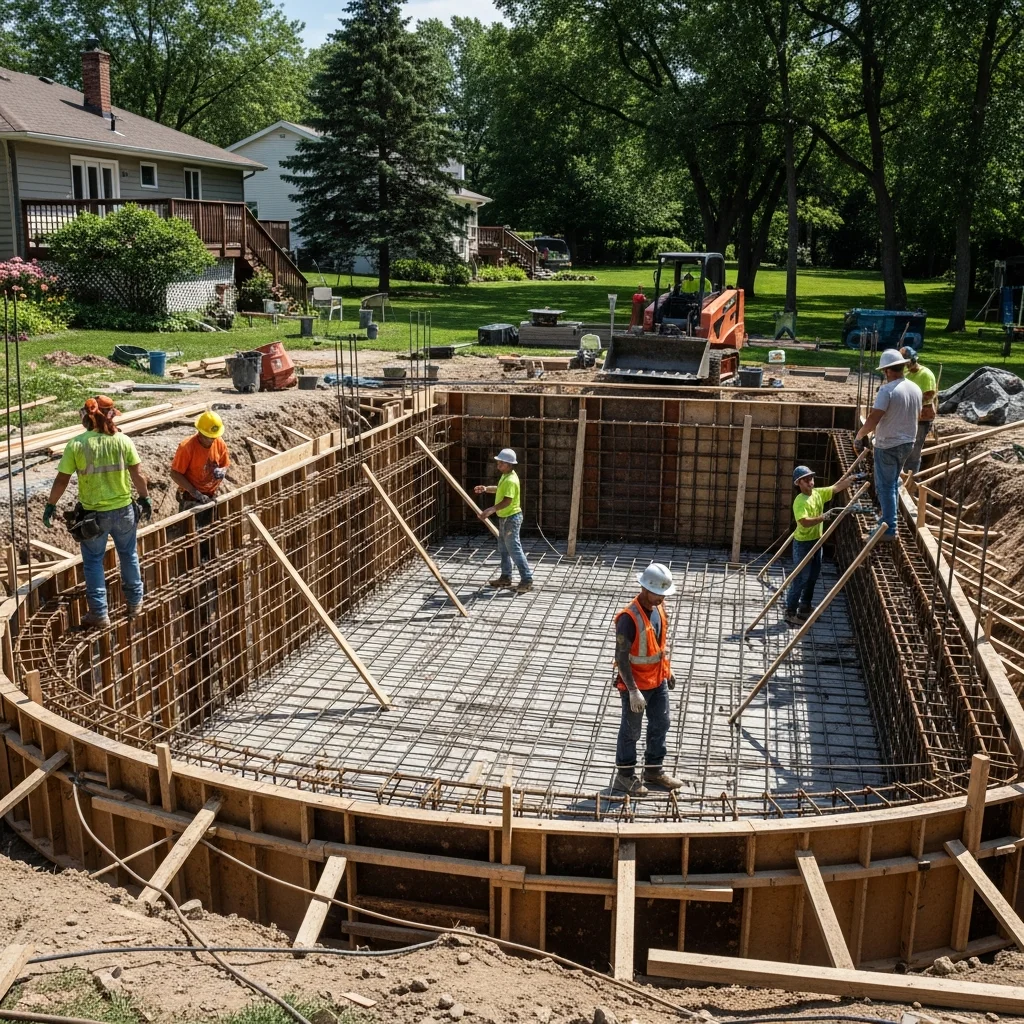

Shell Construction (Gunite/Shotcrete)

Line ItemUnitQtyUnit CostTotal
Steel rebar grid (#3 rebar, 12” on center)sq ft700$4.25$2,975.00
Gunite/shotcrete applicationsq ft700$12.00$8,400.00
Pool shaping and finishinglump sum1$2,500.00$2,500.00
Waterline tile (6” band)linear ft96$18.00$1,728.00
Interior finish (white plaster)sq ft700$8.50$5,950.00
Coping (precast concrete)linear ft96$28.00$2,688.00

Subtotal: $24,241.00

Notes: Plaster is the budget option for interior finish. Pebble finishes run $12 to $18 per square foot. Quartz finishes fall in between at $10 to $14 per square foot. Tile for the waterline ranges from $12 per linear foot for basic ceramic to $45 or more for glass mosaic.

Plumbing

Line ItemUnitQtyUnit CostTotal
Main drain assembly (dual drain, VGB compliant)each1$450.00$450.00
Return fittingseach4$85.00$340.00
Skimmer assemblyeach2$275.00$550.00
PVC plumbing (2” schedule 40)linear ft180$6.50$1,170.00
Plumbing laborhours16$85.00$1,360.00
Pressure testeach1$200.00$200.00

Subtotal: $4,070.00

Notes: Always install dual main drains to meet VGB (Virginia Graeme Baker Act) requirements. Single main drains are a code violation and a safety hazard. Return fittings should be placed to create proper circulation. For a 16x32 pool, four returns and two skimmers is standard.

Electrical

Line ItemUnitQtyUnit CostTotal
Equipment bonding and groundinglump sum1$800.00$800.00
Sub-panel installation (60A)each1$1,200.00$1,200.00
Wiring to pump, heater, and lightslump sum1$1,800.00$1,800.00
GFI protectioneach2$125.00$250.00
LED pool lights (color-changing)each2$650.00$1,300.00
Light niche installationeach2$175.00$350.00
Electrical permiteach1$250.00$250.00

Subtotal: $5,950.00

Notes: Pool electrical work must be done by a licensed electrician in most states. All pool equipment must be bonded and grounded per NEC Article 680. Light fixtures must be listed for pool use. These are not areas to cut corners.

Equipment

Line ItemUnitQtyUnit CostTotal
Variable speed pump (2.0 HP)each1$1,400.00$1,400.00
Cartridge filter (425 sq ft)each1$850.00$850.00
Gas heater (400,000 BTU)each1$3,200.00$3,200.00
Salt chlorine generatoreach1$1,600.00$1,600.00
Automatic pool control systemeach1$2,200.00$2,200.00
Equipment pad (concrete)each1$600.00$600.00
Equipment installation laborhours12$95.00$1,140.00

Subtotal: $10,990.00

Notes: Variable speed pumps are required by the Department of Energy in most applications as of 2021. They also save the homeowner $50 to $100 per month in energy costs compared to single-speed pumps. Salt chlorine generators are increasingly popular and justify a higher price point. Budget chlorine systems (tablet feeders) cost around $200 to $400 instead.

Decking and Hardscape

Line ItemUnitQtyUnit CostTotal
Concrete pool deck (brushed finish)sq ft600$9.50$5,700.00
Expansion jointslinear ft80$3.00$240.00
Deck drain (linear channel)linear ft20$45.00$900.00

Subtotal: $6,840.00

Notes: Stamped concrete runs $14 to $20 per square foot. Pavers cost $18 to $30 per square foot installed. Travertine or natural stone runs $25 to $50 per square foot. The decking is often where homeowners want to upgrade, so have pricing ready for multiple options.

Fencing and Safety

Line ItemUnitQtyUnit CostTotal
Aluminum pool fence (54” height, code compliant)linear ft120$32.00$3,840.00
Self-closing, self-latching gateeach2$425.00$850.00
Gate alarmeach2$85.00$170.00

Subtotal: $4,860.00

Notes: Pool fencing requirements vary by jurisdiction but typically require a minimum 48-inch barrier with self-closing, self-latching gates. Some areas accept the home itself as one side of the barrier if doors have alarms. Check your local codes before quoting fencing.

Permits and Fees

Line ItemUnitQtyUnit CostTotal
Building permit (pool construction)each1$1,500.00$1,500.00
Electrical permiteach1$250.00$250.00
Engineering drawingseach1$800.00$800.00
Municipal inspections (included with permits)each1$0.00$0.00

Subtotal: $2,550.00

Startup and Commissioning

Line ItemUnitQtyUnit CostTotal
Pool fill watergallons18,000$0.01$180.00
Chemical startup kiteach1$350.00$350.00
System startup and programminghours4$95.00$380.00
Customer orientation and traininghours2$0.00$0.00

Subtotal: $910.00

Summary for New Pool Construction

CategoryAmount
Excavation and Site Work$9,320.00
Shell Construction (Gunite/Shotcrete)$24,241.00
Plumbing$4,070.00
Electrical$5,950.00
Equipment$10,990.00
Decking and Hardscape$6,840.00
Fencing and Safety$4,860.00
Permits and Fees$2,550.00
Startup and Commissioning$910.00
Direct Cost Subtotal$69,731.00
Overhead (12%)$8,367.72
Profit (15% on direct cost + overhead)$11,714.81
Total Estimate$89,813.53

Template 2: Pool Renovation and Remodel

Renovation work is bread and butter for many pool contractors. Homeowners with aging pools need resurfacing, equipment upgrades, tile replacement, and sometimes a complete remodel. These jobs carry better margins than new construction because you are working with an existing structure.

Common Renovation Line Items

Line ItemUnitQtyUnit CostTotal
Drain pool and acid washeach1$450.00$450.00
Remove existing plastersq ft550$3.50$1,925.00
Repair cracks and spallinglump sum1$1,200.00$1,200.00
New interior finish (pebble)sq ft550$14.00$7,700.00
Replace waterline tilelinear ft80$22.00$1,760.00
Replace coping (natural stone)linear ft80$38.00$3,040.00
Replace main drain covers (VGB compliant)each2$125.00$250.00
Replace return fittingseach4$65.00$260.00
Replace skimmer lids and basketseach2$85.00$170.00

Subtotal: $16,755.00

Equipment Upgrades

Line ItemUnitQtyUnit CostTotal
Replace single-speed with variable-speed pumpeach1$1,400.00$1,400.00
New cartridge filtereach1$850.00$850.00
New salt chlorine generatoreach1$1,600.00$1,600.00
LED light retrofit (2 lights)each2$550.00$1,100.00
New automation controllereach1$2,200.00$2,200.00
Replumb equipment padlump sum1$1,800.00$1,800.00
Equipment installation laborhours10$95.00$950.00

Subtotal: $9,900.00

Optional Add-Ons

Line ItemUnitQtyUnit CostTotal
Water feature (sheer descent)each1$2,800$2,800
Fire bowls (propane)each2$1,200$2,400
Deck resurfacing (spray deck coating)sq ft500$7.00$3,500
Add spa spillover to existing poollump sum1$15,000$15,000

Summary for Pool Renovation

CategoryAmount
Common Renovation Line Items$16,755.00
Equipment Upgrades$9,900.00
Direct Cost Subtotal$26,655.00
Overhead (12%)$3,198.60
Profit (18% on direct cost + overhead)$5,373.65
Total Estimate$35,227.25

Notes: Renovation work supports higher profit margins because labor is the biggest cost driver and you control the pace. Material costs are lower relative to new construction, so your markup has more room.


Template 3: Pre-Fabricated Hot Tub Installation

This template covers a drop-in acrylic hot tub on a new concrete pad, with electrical sub-panel, wiring, and startup. Swap in your own unit and electrical run for each job.

Line Items

Line ItemUnitQtyUnit CostTotal
Hot tub unit (6-person, mid-range)each1$8,500.00$8,500.00
Delivery and crane placementeach1$600.00$600.00
Concrete pad (10x10, 4” thick)sq ft100$9.50$950.00
Electrical sub-panel (50A, 240V)each1$1,400.00$1,400.00
Wiring from main panel (up to 50 ft)lump sum1$1,200.00$1,200.00
GFCI disconnecteach1$350.00$350.00
Electrical permiteach1$200.00$200.00
Startup and customer traininghours2$95.00$190.00

Subtotal: $13,390.00

Summary

CategoryAmount
Line Items$13,390.00
Direct Cost Subtotal$13,390.00
Overhead (12%)$1,606.80
Profit (15% on direct cost + overhead)$2,249.52
Total Estimate$17,246.32

Template 4: Custom Built-In Spa

This template covers a custom gunite built-in spa with its own plumbing loop, heater, and electrical circuits, spilling over into an existing pool.

Line Items

Line ItemUnitQtyUnit CostTotal
Excavation (8x8, 4ft depth)lump sum1$1,800.00$1,800.00
Gunite shell constructionsq ft180$14.00$2,520.00
Interior finish (pebble)sq ft180$14.00$2,520.00
Tile and copinglinear ft32$28.00$896.00
Spa jets (hydrotherapy)each12$65.00$780.00
Air blowereach1$450.00$450.00
Dedicated spa pump (2.5 HP)each1$900.00$900.00
Spa heater (gas, 200,000 BTU)each1$2,400.00$2,400.00
Plumbing (dedicated spa loop)lump sum1$2,200.00$2,200.00
Electrical (spa circuits)lump sum1$1,800.00$1,800.00
LED spa light (color-changing)each2$450.00$900.00
Spillover edge into poollump sum1$1,500.00$1,500.00
Permitslump sum1$1,000.00$1,000.00

Subtotal: $19,666.00

Summary

CategoryAmount
Line Items$19,666.00
Direct Cost Subtotal$19,666.00
Overhead (12%)$2,359.92
Profit (15% on direct cost + overhead)$3,303.89
Total Estimate$25,329.81

Tips for Accurate Pool and Spa Estimates

1. Always visit the site first. Pool estimates based on phone calls or satellite images are guesses. You need to see soil conditions, access points, slope, existing utilities, and the overall yard layout. A 30-minute site visit can save you from a $10,000 mistake.

2. Check soil conditions before quoting excavation. If the property has rocky soil, a high water table, or expansive clay, your excavation cost can double or triple. Some contractors include a soil contingency line item of $2,000 to $5,000 for unknown conditions.

3. Get subcontractor quotes in writing. If you are subbing out electrical, excavation, or fencing, get firm quotes before including those numbers in your estimate. Verbal estimates from subs have a way of going up when the invoice arrives.

4. Include a clear payment schedule. Pool projects are expensive and take weeks to complete. Most contractors use a milestone payment schedule: 10% at contract signing, 25% at excavation, 25% at shell completion, 25% at equipment and decking, and 15% at final completion. Put this on your estimate so the homeowner knows when money is due.

5. Price options separately. Homeowners love options. List the base pool price, then show add-ons like water features, upgraded finishes, automation, and lighting as separate line items. This lets the customer pick and choose without requiring a new estimate.

6. Account for access and logistics. Moving equipment, materials, and concrete trucks through a residential property is not always simple. If the backyard has limited access, you may need a concrete pump ($800 to $1,500), a smaller excavator (slower and more expensive), or hand-carrying of materials. Include these costs.

7. Factor in seasonal pricing. In many markets, pool construction prices drop 10% to 15% in the off-season (fall and winter). If you are bidding a project that will start in January, you may be able to pass some of those savings to the customer while maintaining your margin.

8. Do not forget the warranty. State your warranty terms on the estimate. Common coverage includes 1 year on labor, 2 to 5 years on equipment (manufacturer warranty), and 10 to 25 years on the shell structure. Clear warranty terms build trust and reduce disputes.


Common Mistakes in Pool Estimates

Underestimating excavation costs. This is the number one margin killer in pool construction. Bad soil, rock, tight access, and long haul distances can add $5,000 to $15,000 to a job. Build a buffer or specify exclusions for unknown conditions.

Forgetting about water and sewer fees. Filling a pool uses 15,000 to 25,000 gallons of water. Some municipalities charge sewer fees on all water usage. A $200 water bill can turn into an $800 surprise if the customer gets a sewer surcharge.

Not including final grading and cleanup. After the pool is installed, the yard looks like a construction zone. Grading, soil removal, and landscaping restoration can cost $2,000 to $5,000. If you do not include it, the customer will expect it for free.

Ignoring code requirements. Pool fencing, electrical bonding, drain covers, and barrier requirements vary by location. A missed code item during inspection means rework on your dime. Research local codes before you quote.

Using old pricing. Concrete, steel, PVC pipe, and pool equipment have all seen price increases in recent years. If your template still has 2023 pricing, you could be undercharging by 15% to 25%. Update your costs every quarter.


How Projul Helps Pool and Spa Contractors

Building estimates in spreadsheets works until you are juggling five or six jobs at once. Then things start falling through the cracks. You forget to follow up on an estimate. You cannot find the revision you sent two weeks ago. You have no idea which estimates are pending, accepted, or expired.

Projul’s estimating tools are built for contractors who want to spend less time on paperwork and more time building pools. Here is what that looks like in practice:

Saved line item libraries. Build your pool and spa line items once, then pull them into any estimate with a few clicks. Your excavation, plumbing, electrical, and equipment items are always ready to go with your current pricing.

Estimate templates. Create templates for your most common job types: new construction, renovation, spa installation. Start with a template, adjust quantities and pricing for the specific project, and send it to the customer the same day you visit the site.

Customer-facing proposals. Your estimates go out as clean, branded proposals that the customer can review and approve online. No more emailing PDFs back and forth.

Change order tracking. When the homeowner wants to add a water feature or upgrade the finish, create a change order tied to the original estimate. Both you and the customer can see exactly what changed and how it affects the total.

AI help on the Pro plan. With Projul AI Connect, you can ask ChatGPT, Claude, or another AI assistant which estimates still need a follow-up, or have it draft that water feature change order from your meeting notes. Nothing goes to the homeowner until you send it.

Job costing integration. Once an estimate is approved, it flows into your project. Track actual costs against your estimate throughout the job so you know if you are on budget or bleeding money.


Ready to Send Better Pool and Spa Estimates?

These templates give you a solid starting point, but manually copying and pasting line items into spreadsheets is still slow. Projul gives you the full system: estimate templates, line item libraries, customer approvals, change orders, and job costing, all in one place.

Projul Plans:

  • Starter - Estimating, scheduling, and invoicing for crews of up to 3 users
  • Core - Estimating, scheduling, and job management for small pool companies
  • Core+ - Everything in Core plus advanced features for growing teams
  • Pro - Full platform for established pool and spa contractors running multiple crews

See All Pricing Details

Schedule a Demo and see how Projul can help your pool and spa company send winning estimates in less time.

Frequently Asked Questions

How much does it cost to build an inground pool in 2026?
The average cost of a new inground pool in 2026 ranges from $35,000 to $100,000 or more, depending on size, material, and features. A basic 12x24 vinyl liner pool starts around $35,000 to $45,000. A gunite or shotcrete pool of the same size runs $50,000 to $70,000. Add features like a spa, waterfall, or automatic cover, and you can easily push past $100,000. Always price your local market, because concrete and labor costs vary widely by region.
What should be included in a pool estimate?
A complete pool estimate should list excavation, shell construction (vinyl, fiberglass, or gunite), plumbing, electrical work, the filtration and pump system, decking or coping, permits, and any add-ons like lighting, heaters, or water features. Break each section into its own line item with quantities, unit costs, and totals. This helps the homeowner see exactly where their money goes and reduces questions later.
How long does a pool installation take?
A vinyl liner pool typically takes 4 to 6 weeks. Fiberglass pools can be installed in 2 to 4 weeks since the shell arrives pre-made. Gunite or shotcrete pools take the longest, usually 8 to 14 weeks, because the concrete needs time to cure before finishing. Weather delays, permit timelines, and custom features can all add time. Include a realistic timeline range in your estimate so the homeowner knows what to expect.
How much profit margin should a pool contractor target?
Most successful pool contractors work with a gross margin between 30% and 45%. New pool construction tends to land in the 30% to 38% range because of high material costs. Renovation and remodel work often hits 40% to 50% because the labor-to-material ratio favors the contractor. If your margins are consistently below 25%, you are either underpricing or your overhead is too high.
Should I charge separately for pool permits and inspections?
Yes. Always list permits and inspection fees as their own line items. Pool permits can cost anywhere from $500 to $3,000 depending on your city and county. If you bury these costs inside other line items, you eat them when they come in higher than expected. Showing them separately also signals to the customer that you follow local codes and pull proper permits.
No pushy sales reps Risk free No credit card needed
